Housing Developments


Riverside” Housing Development (Old Creamery Site)

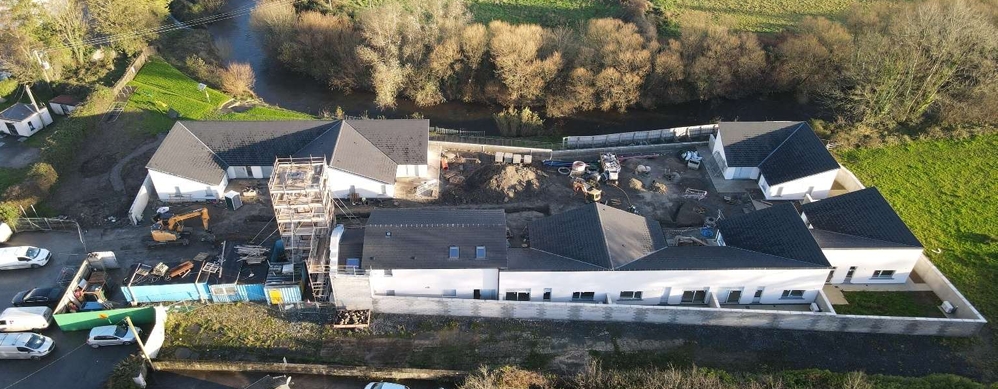

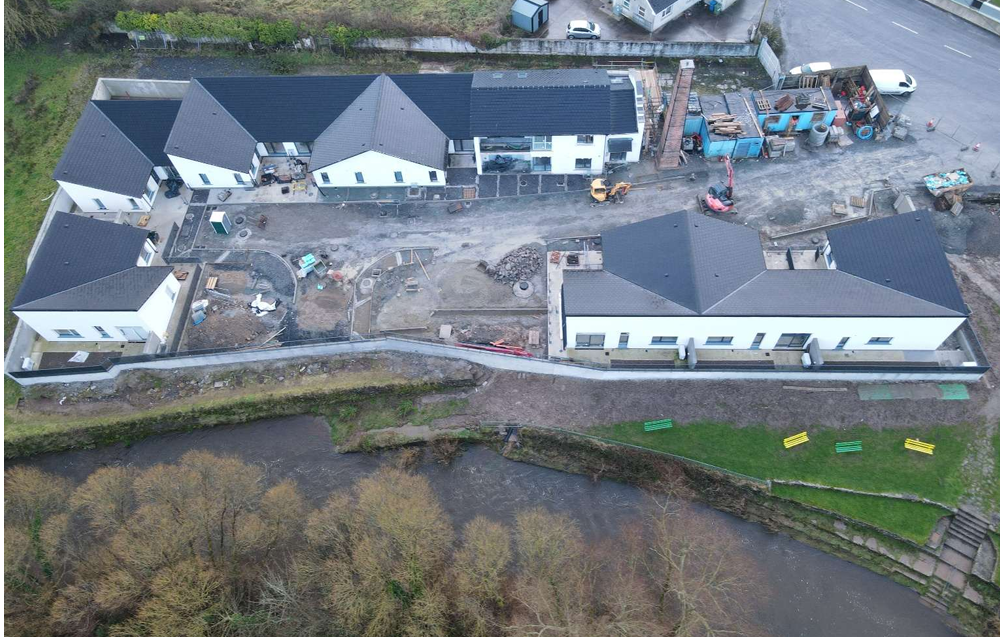

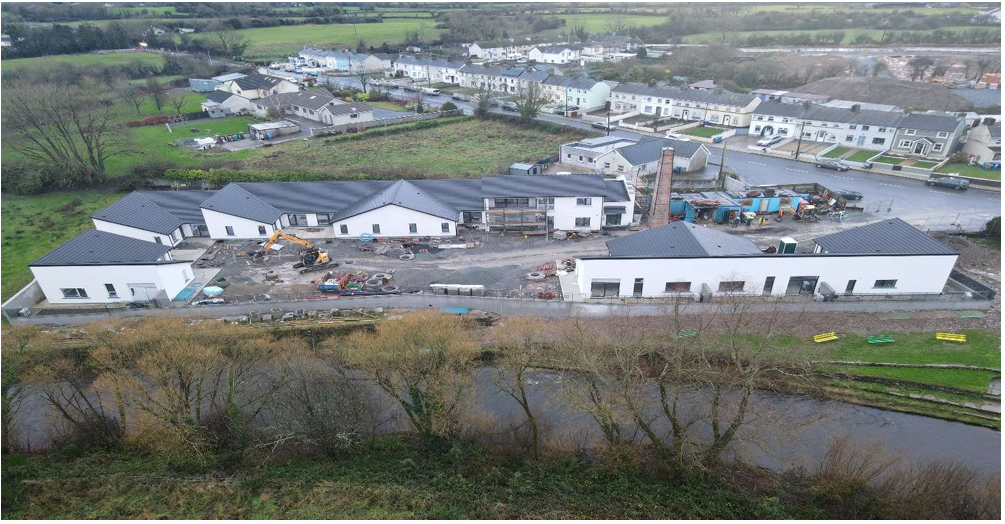

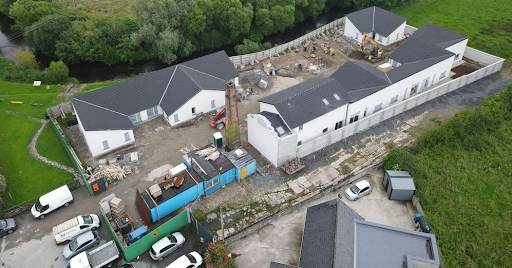

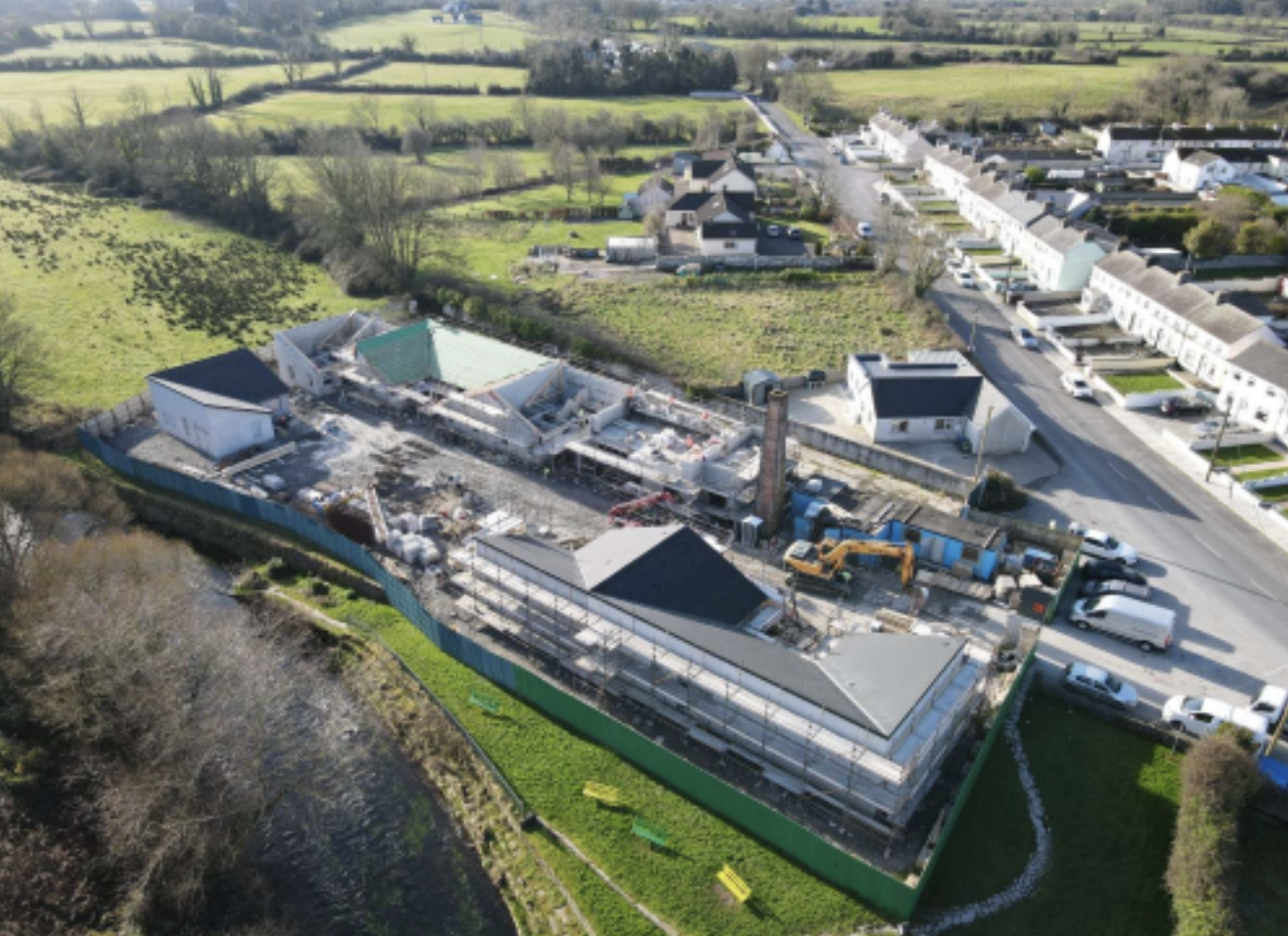

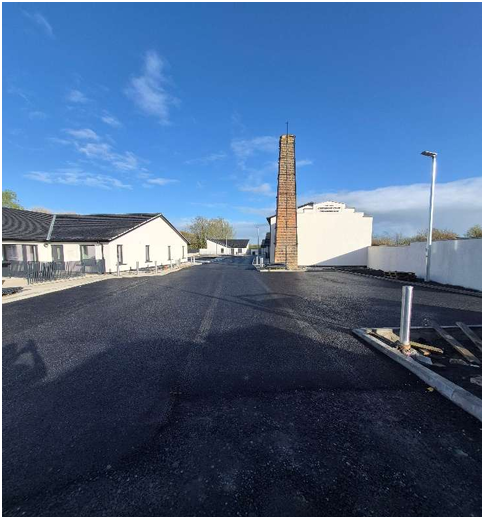

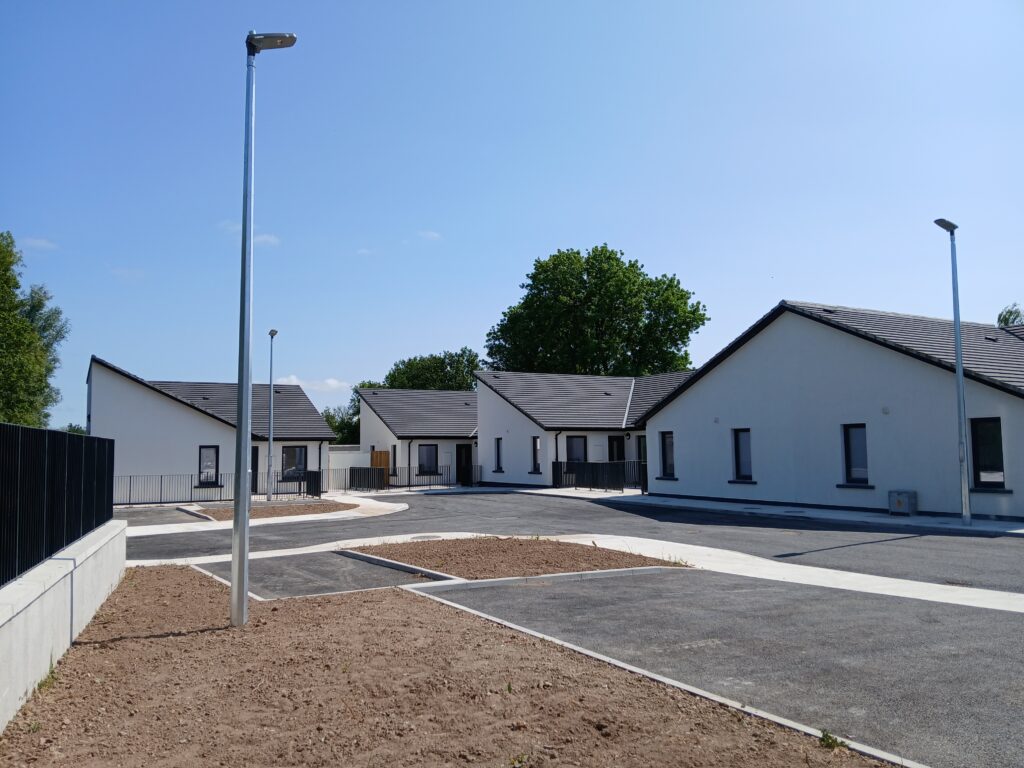

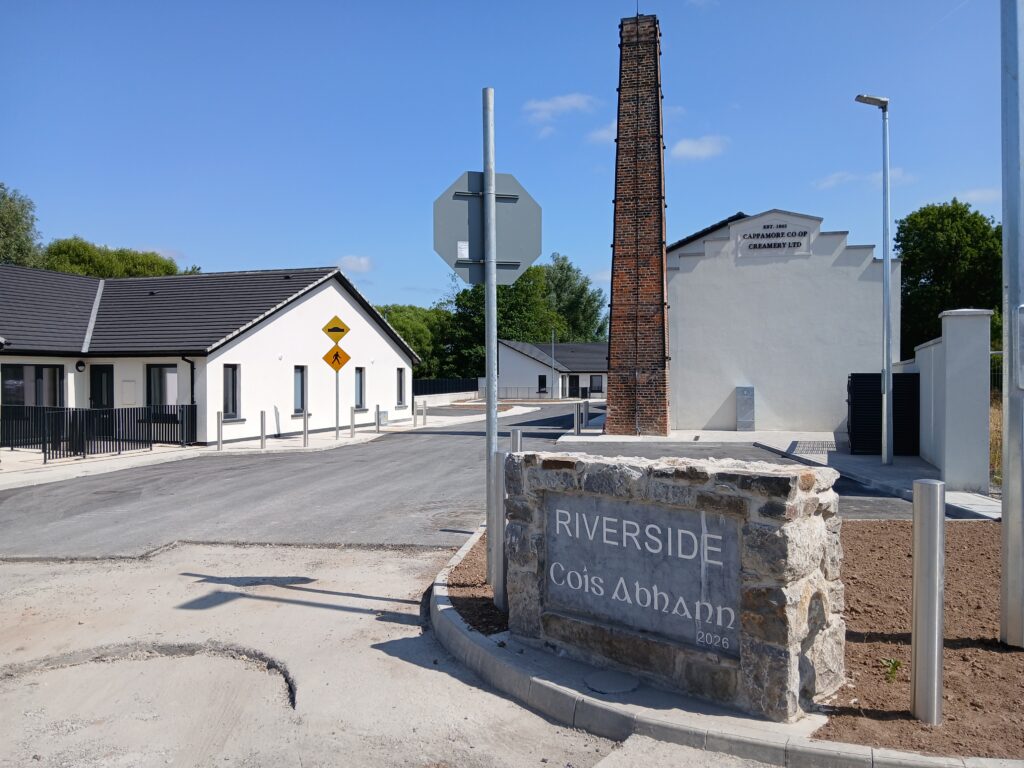

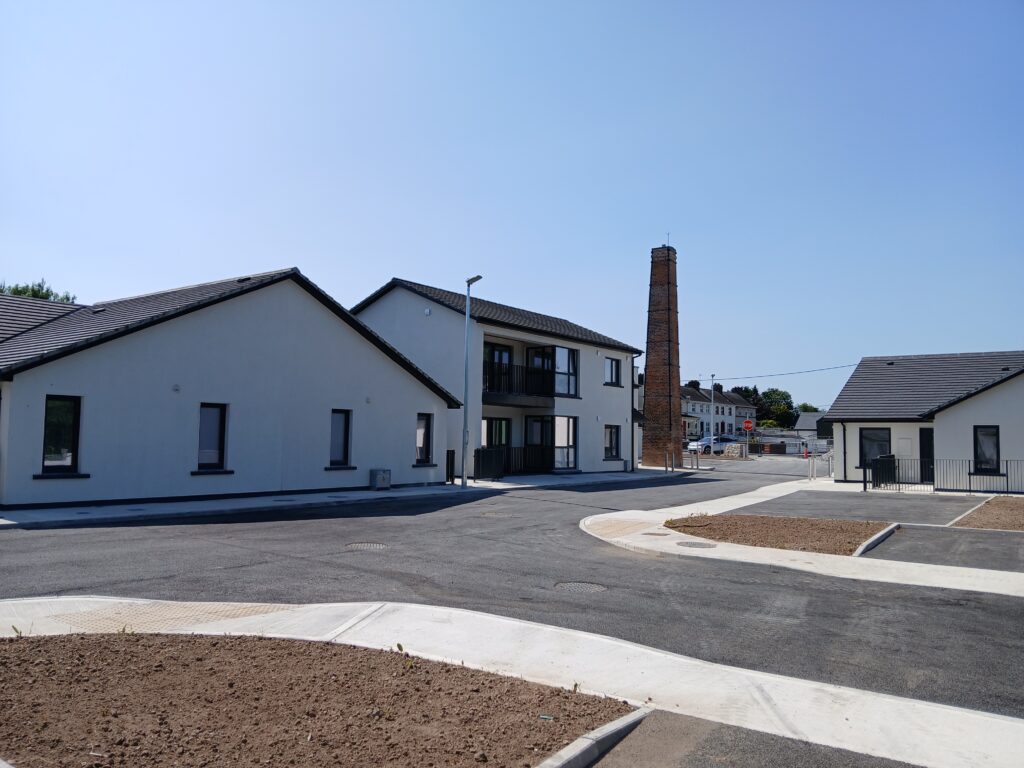

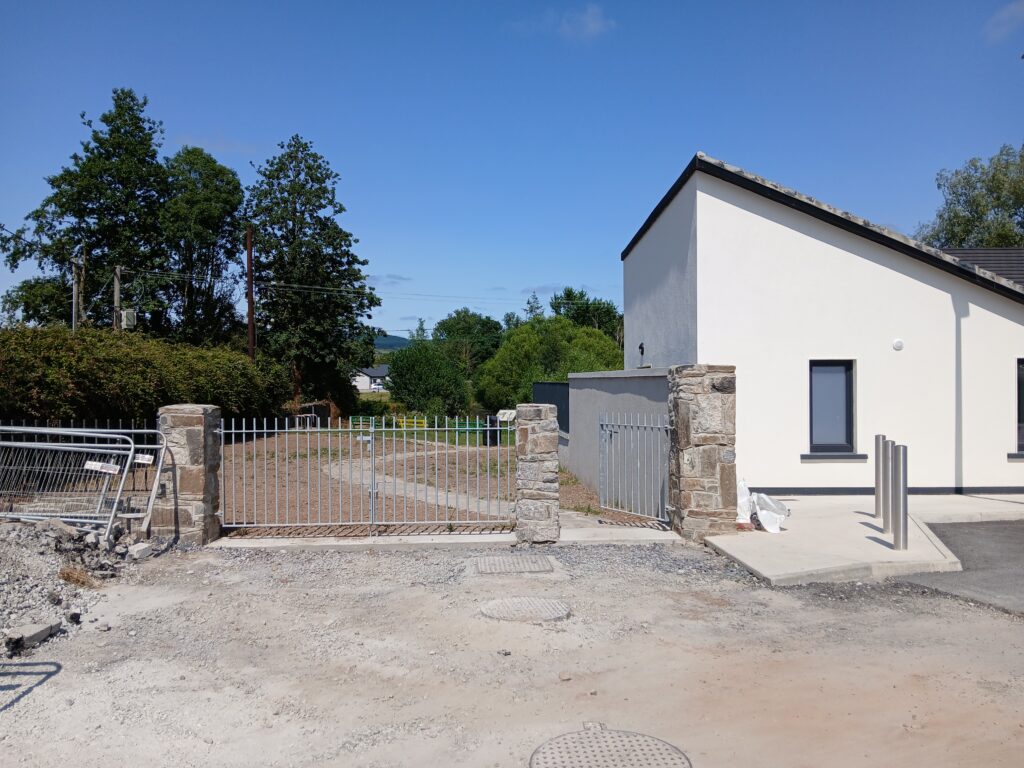

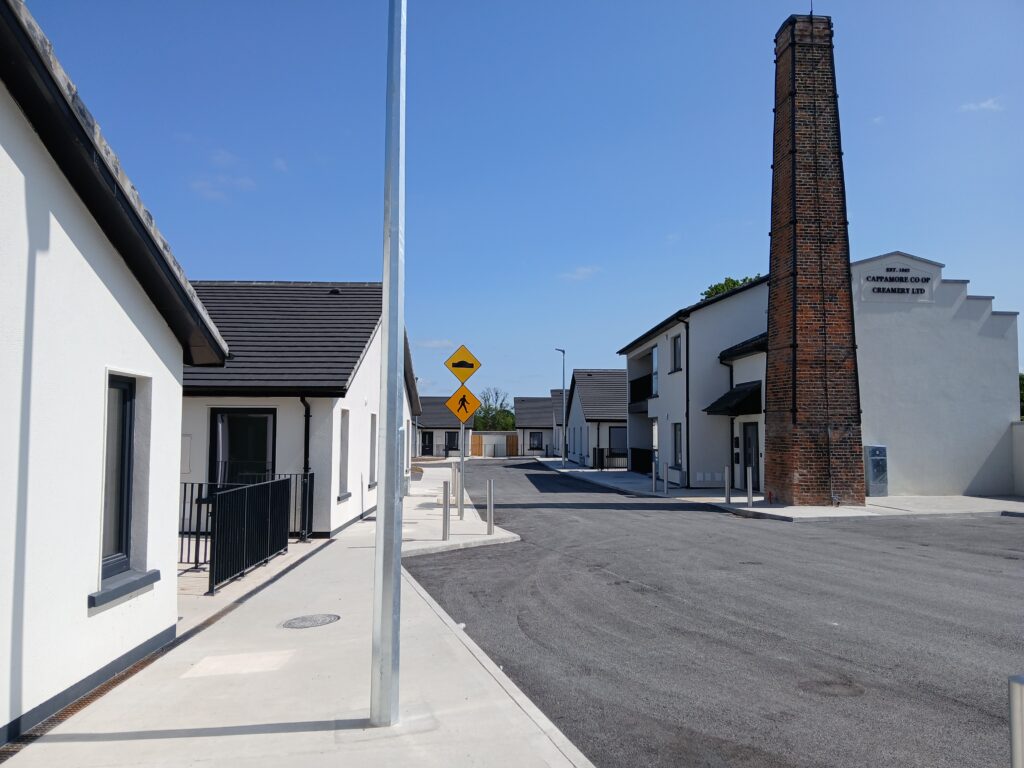

Check out updated photos of the Riverside development at the end of this page

Development consists of 10 Units comprising of eight houses and two apartments

  • Development Location: Turagh, Cappamore, Co. Limerick
  • Planning Permission Number: 19/872
  • Local Authority: Limerick City and County Council
  • Commencement date of development: Wednesday, 24th April, 2024
  • Builders Name: Martins Construction Ltd.
  • Designer Name:  Healy Partners (Architects)

Riverside development update dated 18/07/2026

ESB electricity connection works completed.

Commissioning of home heating systems to commence.

All houses/apartments have now been allocated and successful tenants have been notified.

Riverside development update dated 02/07/2026

Irish Water connection works completed.

ESB due back on site to connect electricity supply to the housing development on 15/07/2026

Riverside development update dated 04/06/2026

Irish Water connection works to commence on 9th June

Riverside development update from Building Contractor
Dated 13/04/2026

  • House 1-10
    • Rainwater Goods – 95% Completed
    • External Windows/Doors – Completed
    • Internal Works – Completed
    • External Painting – 95% Completed
    • Apartment Stairwell – Completed
    • Boundary Wall – Completed
    • Boundary Railings – Completed
    • Footpaths – Completed
    • Kerbs – Completed
    • Attenuation Tank – Completed
    • Surface & Foul Drainage – Completed to boundary
    • Mains Water system – Completed to boundary
    • Chimney – Completed
    • Bollards – Completed
    • House Railings – Completed
    • Road Build Up – Completed
    • Street Lighting – Completed
    • Council Snags – Completed
    • Site Office & Storage – Removed from site
    • River Park Railing/Gates – Completed
    • Tarmac – Completed to sited entrance
    • Bin Stores – On site
    • ESB – Connection works commenced. Power due to be connected in April

Top Project Risk

Irish Water – Connection Date Required

Two Week Look Ahead

Paving to commence

Line marking to commence

Bin stores to be fitted

Landscaping to commence

Apartment Stairwell Flooring to commence
